2026 Watermain Renewal Program

Project Type
Roads
Underground Infrastructure
Project #
EN1537
Status
In Progress
Estimated Completion
Fall 2026

The City of Barrie will complete watermain renewal work in the Shanty Bay Road area from spring 2026 through fall 2026 to improve water infrastructure reliability and service for residents.

Project Updates

October 21, 2026

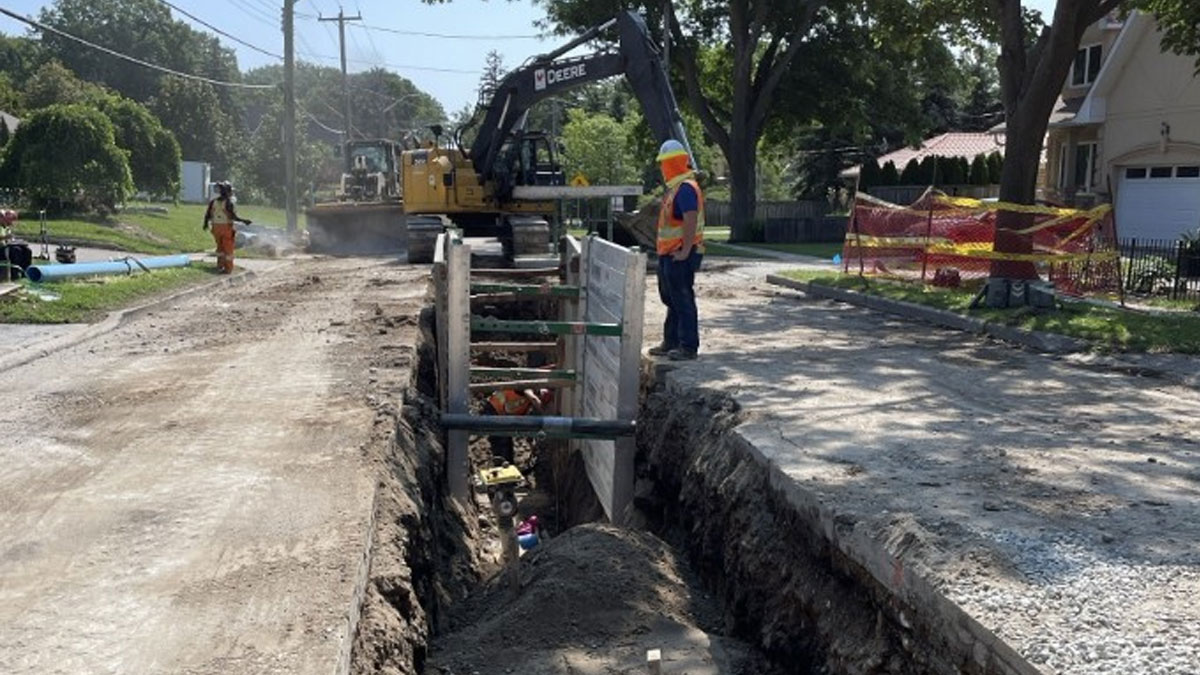

Construction continues to progress. The following work and road/lane closures are currently ongoing:

  • Shanty Bay Road (Blake Street to Johnson Street)
    Concrete curb installation and base asphalt paving are now complete. Sidewalk, driveway and boulevard restoration work is scheduled to take place over the coming weeks. Lane closures and shifts are expected to remain in place until November 27, 2026.
  • Shanty Bay Road (Johnson Street to Crestwood Drive)
    Concrete curb removal and installation, catch basin replacements, and asphalt resurfacing are currently underway. Sidewalk, driveway and boulevard restoration work is scheduled to take place over the coming weeks. Lane closures and shifts are expected to remain in place until November 3, 2026, followed by a road closure November 3–27, 2026. Motorists are to follow the signed detour route.
  • Shanty Bay Road (Crestwood Drive to Penetanguishene Road)
    Watermain and water service installation is now complete. Concrete curb removal and installation, along with asphalt resurfacing, are currently underway. Driveway and boulevard restoration work is scheduled to take place over the coming weeks. Lane closures and shifts are expected to remain in place until November 27, 2026.
  • Crestwood Drive (Shanty Bay Road to Baycrest Drive)
    Watermain and water service installation is now complete. Concrete curb removal and installation are currently underway. Asphalt resurfacing, driveway and boulevard restoration work is scheduled to take place over the coming weeks. Lane closures and shifts are expected to remain in place until November 27, 2026.
  • Vancouver Street (Blake Street to Kempenfelt Drive)
    Roadway, curb, sidewalk, driveway and boulevard restoration work is scheduled to take place over the coming weeks. Lane closures and shifts are expected to remain in place until November 27, 2026.

Signed detour routes will be in place to guide motorists around road closures. For additional information and current road closure details, visit barrie.ca/RoadClosures.

Scope of Work

The project includes:

  • Watermain lining in existing watermain (trenchless method of installation) along with a temporary watermain system to maintain water service during construction;
  • New watermain (open-cut method of installation);
  • Pressure reducing valve (PRV) chamber at Shanty Bay Road and Crestwood Drive;
  • New fire hydrants, water valves and water services;
  • Removing and replacing the curb, asphalt roadways, driveways and boulevards impacted by work.

Construction Areas and Planned Work

LocationPlanned Work
Vancouver Street, Kempenfelt to BlakeWatermain lining
Blake Street, Vancouver to Shanty BayWatermain lining and new watermain crossing
Shanty Bay Road, Blake to PugetWatermain lining, curb and driveway replacement, and full-depth asphalt restoration
Shanty Bay Road, Puget to JohnsonNew watermain and services, curb and driveway replacement, and full-depth asphalt restoration
Shanty Bay Road, Johnson to CrestwoodWatermain lining, curb and driveway replacement, and full-depth asphalt restoration
Shanty Bay Road, Crestwood to PenetanguisheneNew watermain, curb and driveway replacement, and full-depth asphalt restoration
Crestwood Drive, Shanty Bay to PenetanguisheneNew watermain, east-side curb and driveway replacement, full-depth asphalt restoration, and PRV chamber installation

About Watermain Lining

Watermain lining is a trenchless construction method that installs a new liner inside the existing pipe. Compared to traditional open-cut excavation, this method:

  • Reduces disruption to roads and surrounding properties;
  • Minimizes traffic impacts and construction time;
  • Requires less restoration work;
  • Extends the life of the existing watermain with reduced environmental impact.

Open-cut excavation is still required in areas where the watermain size must change or where the existing watermain contains significant bends or changes in pipe size.

Traffic and Access

  • The Johnson’s Beach parking lot will remain open throughout construction.
  • Pedestrian access will be maintained throughout construction, and emergency vehicle access will always be provided.
  • Most streets within the construction area are expected to maintain at least one lane of traffic during regular construction hours. Temporary lane reductions and traffic delays can be expected.

The following temporary road closures are anticipated:

  • Shanty Bay Road between Puget and Johnson (west side of intersection): Full road closure for approximately five weeks.
  • Shanty Bay Road between Crestwood (east side of intersection) and Penetanguishene: Full road closure for approximately three weeks.
  • Crestwood Drive between Shanty Bay and Penetanguishene: Full road closure for approximately five weeks. Access through the intersection of Crestwood Drive and Shanty Bay Road will be maintained.
