May 8, 2026

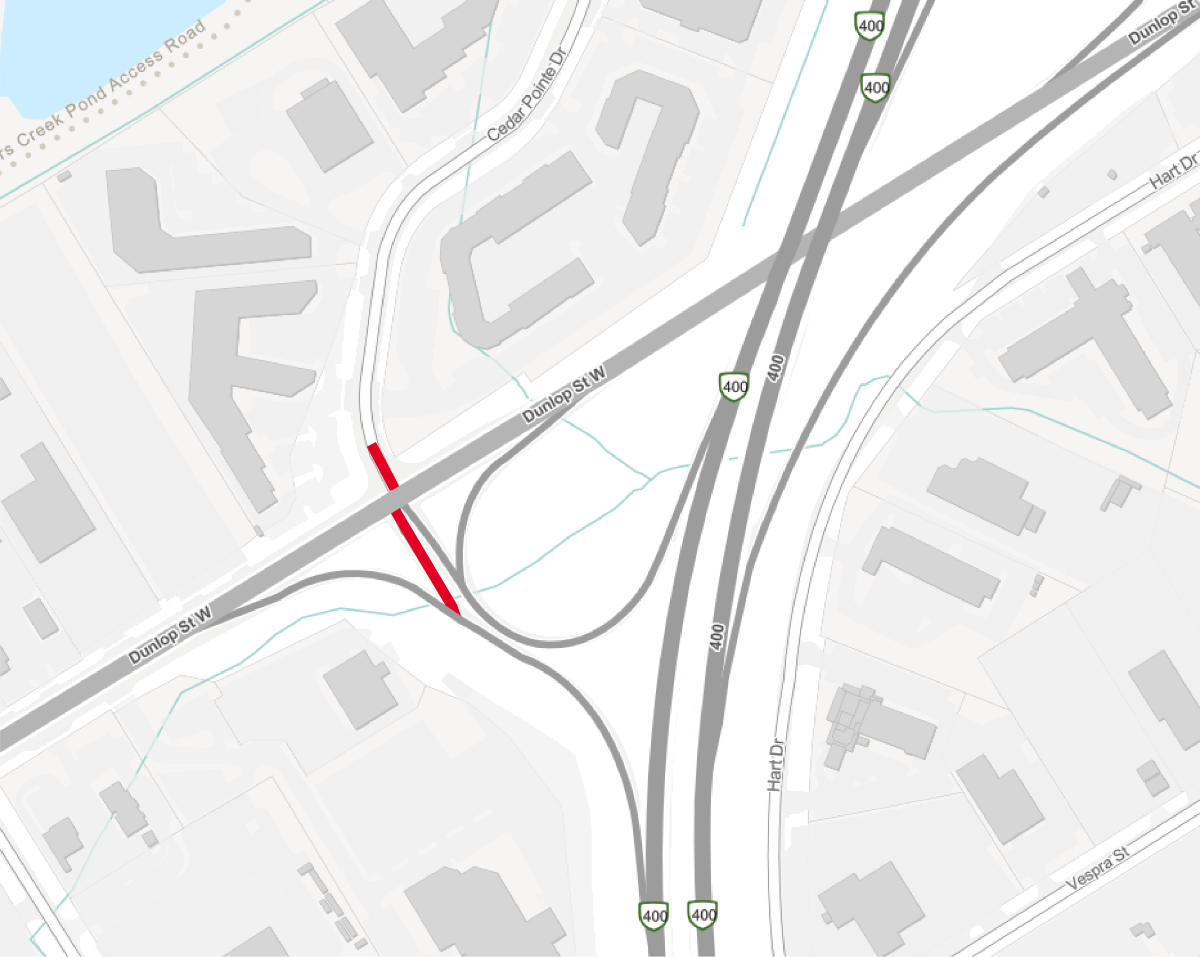

The MTO’s contractor will implement single lane closures on Dunlop Street West from Cedar Pointe to Sarjeant, both eastbound and westbound. These closures will start on Monday, May 11 at 7am and are expected to be in place until Friday, May 29 at 5pm. The closures are required to complete watermain installation on Dunlop and Cedar Pointe.
This work will also require overnight interruptions/closures at the Dunlop/Cedar Pointe and Dunlop/Sarjeant intersections. Further details will be available once confirmed.
May 1, 2026
The MTO’s contractor will require overnight closures on Dunlop Street West from Cedar Pointe Drive to Hart Drive for three nights starting Tuesday, May 5.
The road will be closed 10pm–5am each night so crews can complete bridge piling for the new west‑side bridge abutment. The southbound and northbound Highway 400 off-ramps at Dunlop will also be closed during construction.
Detours will direct traffic along Anne Street, Edgehill Drive, Ferndale Drive and Tiffin Street.
April 10, 2026
The MTO's contractor will return to Dunlop Street next week with lane closures anticipated to begin Tuesday, April 14.
Specifically, lane closures are planned on Dunlop Street from Anne to Hart, as well as restrictions to and from Hart Drive as follows:
- Tuesday, April 14: Closure of the inside lanes, with traffic shifted to the outside lanes in both westbound and eastbound directions
- Wednesday, April 15: Closure of the westbound curb lane and the northbound left turn lane on Hart Drive
- Thursday, April 16: Closure of the eastbound curb lane and the northbound right turn lane on Hart Drive
Daily closures will begin at 6am and be removed at the end of the work day.
Details on Barrie Transit impacts will be available at MyRideBarrie.ca/News.
December 8, 2025
Work on Dunlop Street West has progressed over the last several months with road widening and storm sewers completed in the area of Hart Drive and Anne Street. The MTO's contractor has made significant progress on the new interchange ramps and noise barrier wall installation. Work on Dunlop Street West has now been paused for the winter.
However, work on the new bridge will continue through the winter with pile installation ongoing for the bridge abutments south of the existing bridge.
The contractor's full operations will restart again in spring 2026.
September 30, 2025
The MTO's contractor will close a single westbound lane of Dunlop Street from east of Anne Street to Hart Drive. The closure is expected to be in place from 6am on Monday, October 6 until Friday, October 10 at 5pm. This closure is required to complete lane widening and storm sewer works.
September 19, 2025
The MTO's contractor will be closing a single eastbound lane of Dunlop Street from Hwy 400 to Anne Street. The closure is expected to be in place from 6am on Monday, September 22 until Friday, September 26 at 5pm. This closure is required to complete lane widening and storm sewer works.
August 26, 2025
The MTO's contractor has watermain work planned for Wednesday, August 27 that will impact traffic at the Dunlop and Anne intersection. The contractor will be implementing lane closures, traffic restrictions, and lane shifts on Dunlop Street West, Anne Street, and through the Dunlop/Anne intersection. One lane of traffic will be maintained in all directions throughout the work, however delays should be expected from 5am until 4pm. A paid duty police officer will be on site to assist with traffic control.
August 8, 2025
MTO's contractor, North Rock Group, a subcontractor of Dufferin Construction Ltd., have the following activities planned around the intersection of Dunlop and Anne during the week of August 11. Lane closures on Dunlop Street and Hart Drive will be required and a paid duty officer will be on site.
- Watermain Investigation: Localized work at the intersection is scheduled for Monday, August 11, between 9am and 3pm. The investigation is expected to take 2–3 hours within a confined 6mx6m area.
- Interim Watermain Tie-in at Hart & Dunlop: The tie-in on Hart (near the Hart & Dunlop intersection) is currently scheduled for Wednesday, August 13, during the day.
- Interim Watermain Tie-in at Dunlop & Anne: The results of the above investigation will confirm the timing of the watermain tie-in at the intersection, which is currently planned for the night of Thursday, August 14, from 9pm to 6am the next day. The night of Sunday, August 17 will be a contingency, if needed.
The final watermain tie-ins for both locations are scheduled for the week of August 18. Further details will be shared once confirmed.
July 11, 2025
The contractor's planned lane closure of one eastbound lane of Dunlop Street has been postponed by one week. A single eastbound lane will be closed from west of Hart Drive to Anne Street; anticipated lane closure dates are July 21–August 8. Access to businesses and pedestrian routes will be maintained. This lane closure is required for watermain work. Those impacted by any planned water outages will be provided notice in advance.
July 3, 2025
Work has begun on the Dunlop Street interchange with activity focused on the new northbound Highway 400 on-ramp and pre-staging work on Dunlop Street bridge and Highway 400.
The contractor will have one eastbound lane of Dunlop Street closed from west of Hart Drive to Anne Street; anticipated lane closure dates are July 14–August 1. Access to businesses and pedestrian routes will be maintained. This lane closure is required for watermain work. Those impacted by any planned water outages will be provided notice in advance.
May 5, 2025
The MTO has awarded the project to Dufferin Construction Company (Dufferin).
Dufferin will start their work on Dunlop Street next week. The overall project, which includes impacts to Dunlop Street and Highway 400 is expected to take four years to complete. The anticipated completion is fall 2028.
In the coming weeks, there will be intermittent traffic interruptions on Dunlop Street from Hart to Cedar Pointe, while the work zone is delineated over the existing bridge. Generally, traffic will be maintained along Dunlop Street throughout construction.
Project updates, including road closure information, will be provided as work progresses.
September 12, 2024
The MTO has communicated that the Design and Construction Report (DCR) is available for a 30-day public and external agency review period from September 12, 2024, to October 15, 2024. Interested persons are encouraged to review the DCR by October 15, 2024. The Project Team will respond to all comments generated during the 30-day public review.
For full information, please refer to the Design and Construction Report OGN and the Design and Construction Report posted on MTO's website.
July 24, 2024
The City's Dunlop Street Interchange Trunk Sanitary Relocation project was completed in June (MTO required the City to move the sewer so they can construct the new bridge).
MTO Utility Relocations are underway. All utility relocation work will involve lane shifts as they complete their work in the boulevards.
- Enbridge's relocations are mostly complete, the contractor on site is NPL. Some of their work has been pushed to be completed at night as they work within the Anne Street and Dunlop intersection.
- Alectra is currently doing their relocations along Hart Drive, Dunlop and Cedar Pointe Drive. The contractor doing the work is K-Line.
- Rogers will follow with their relocation works once Alectra has completed their pole relocations.
- Bell will start their relocations when the other utility companies have completed theirs.
