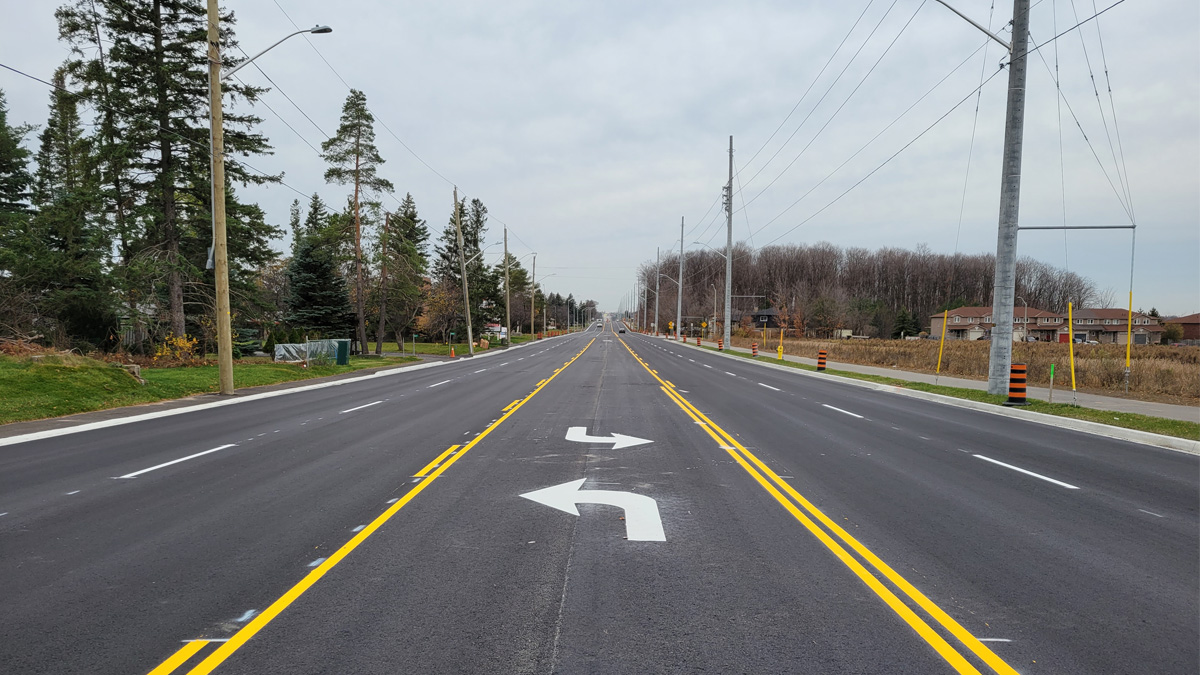

May 1, 2023
The Contractor is completing the last of the restoration. The pavement markings have been recently painted. The concrete bus pads were installed on the south side of the road.
February 2023
The contractor has shut down for the winter months and will be back in the spring to complete the final restoration and address any deficiencies.
December 2022
In November, the following work was completed, bringing the project to substantial
completion, a year ahead of schedule:
- Surface Asphalt placed
- Pavement Markings placed
- Traffic signage installed
Final restoration, and removal of construction equipment and staging area clean up continuing.
November 2022
In September and October 2022, the following work was completed, bringing the project to 95% completion:
- All watermain tie ins completed
- All underground works completed
- Base course asphalt placed
- Driveway restoration completed
- Preparation for the surface asphalt to be placed in November
- Median installed at Dean and Yonge Street
- Final restoration continues
August 2022
- The project is 85% complete.
- Primrose finalizing the underground works on the south side.
- Curb installed from Goodwin to Yonge.
- Boulevard restoration underway on the south side.
- The south side of the road is closed to local residents only, the contractor is in daily communications with them as they progress easterly.
June 28, 2022
- Primrose is installing the sanitary sewer from Madelaine to Dean.
- They are building the south roadway as they progress their works easterly.
- Traffic has been shifted to the north side of the road with accesses at Dean and Goodwin open.
- The south side of the road is closed to local residents only, the contractor is in daily communications with them as they progress easterly.
June 1, 2022
The project is now 70 percent complete and scheduled to be finished by fall 2022. The targeted completion date is one year earlier than originally proposed, and the project remains on budget.
April 2022
Primrose has completed the storm and watermain installation and are preparing the road to be paved in the first week of May.
March 24, 2022
Primrose is back on-site full time with crews completing the remaining storm sewer and watermain installation close to Yonge Street.
January 26, 2022
Primrose is on site completing the watermain tie ins and performing some minor site maintenance. They are mostly off site and will resume construction activities February 2022.
December 3, 2021
Primrose has completed the underground works (watermain and storm sewers) from Goodwin to 120 metres west of Yonge Street. Access to Dean and Goodwin are open as of December 17, 2021. Primrose will be off site from December 23 to January 4th for their holiday season.
November 30, 2021
Primrose is continuing to work on the north side of the road and are installing the underground infrastructure from Dean to Goodwin. They have paved the north side of the road from Madelaine to Dean. Access to Dean and Goodwin will remain closed until December 17, 2021.
October 27, 2021
Primrose is continuing to work on the north side of the road and are installing the underground infrastructure (storm sewers and watermain) from Madelaine to Dean.
October 8, 2021
Construction on Mapleview Drive East from Madelaine Drive to Yonge Street is progressing well. A temporary lane was added on September 21 to allow for two lanes of traffic.
As the project progresses, drivers should be aware of the following upcoming closures:
- Access to Dean Avenue from Mapleview Drive East will be closed off from October 12 to December 17. This is due to a grade difference between the existing Mapleview Drive and Dean Avenue that will prevent vehicular access until the north side is completed.
- Access to Goodwin Drive from Mapleview Drive East will be closed from October 21 to December 17. Similar to Dean Avenue, this is due to the underground infrastructure works and the grade difference between the existing Mapleview road and Goodwin Drive.
August 11, 2021
Lane closures will begin today (Wednesday, August 11). During construction (between 7 a.m. and 7 p.m. Monday to Friday), Mapleview Drive East from Madeline Drive to Yonge Street will be restricted to one lane. Two lanes will open at night and on weekends.
Work completed to date:
- Surveying
- Pre-Condition Surveys
- Traffic Signs
Work anticipated in the month of August
- Installing sediment and erosion control measures
- Initiating the road widening on the south side of the road
- Starting the installation of the watermain installation
July 9, 2021
The City has awarded the construction contract for the Mapleview Drive East Road Improvements Project from Madelaine Drive to Yonge Street to Primrose Contracting Inc. Primrose will be seen on site the week of July 19, 2021. There will be four main activities starting in July:
- Surveying
- Pre-Condition Surveys
- Traffic Signs
- Installing sediment and erosion control measures
In 2021, Primrose plans to install the majority of the watermain works located on the north side of the road. This will include 1300 metres of 600mm diameter watermain and 700 metres of 300mm diameter watermain.
